Garden Suites & Laneway Homes in Toronto: The Landlord's Guide
ArticleToronto, ON

Garden Suites & Laneway Homes in Toronto: The Landlord's Guide

Your lot decides which rulebook you get: touch a public laneway and it's a laneway suite, don't and it's a garden suite. You get one, never both. But the two things most likely to kill the project — emergency access and a protected tree — aren't in the zoning bylaw at all.

One lot line decides which rulebook you get.

If your property touches a public laneway, you're building a laneway suite. If it doesn't, you're building a garden suite. Same backyard, same budget, same ambition — two different sets of rules, and you only ever get one of them.

That's the easy part. The hard part is that the two things most likely to stop your project aren't in the zoning by-law at all. Firefighter access is decided by the Ontario Building Code and Toronto Fire — the City states plainly that those requirements "are not contained in the zoning by-law." And a single protected tree can end a design that pencils perfectly on paper. You can be fully zoning-compliant and still not be able to build.

There's one more thing worth knowing before you read another guide on this topic. Almost all of them tell you to apply for Toronto's development charge deferral. Most readers shouldn't. Since July 24, 2025 the City exempts the second through sixth units in developments of up to six — the charge is zero, there's nothing to defer, and the deferral registers a 20-year agreement against your title.

This guide covers the lane test, the blockers that live outside the by-law, what the City's free pre-approved plans do and don't buy you, where development charges actually stand in 2026, and why the famous $50,000 loan is gone. It's a framework and a method, not legal or construction advice.

The Backyard Suite Feasibility Checklist

Before you pay a designer, find out whether your lot can actually take a suite. Eighteen checks in the order that matters — starting with the one lot line that decides your entire rulebook, and the two blockers that aren't in the zoning by-law at all.

Get Free PDF →

The Lane Test: One Fact Decides Which Rulebook

Start where the City starts. Its garden suite page asks one question before any other: does your site abut a public laneway? If yes, it routes you straight to the laneway suite rules, because — in the City's words — they have different zoning and access regulations than garden suites. If no, you're a garden suite. One lot line, two regimes.

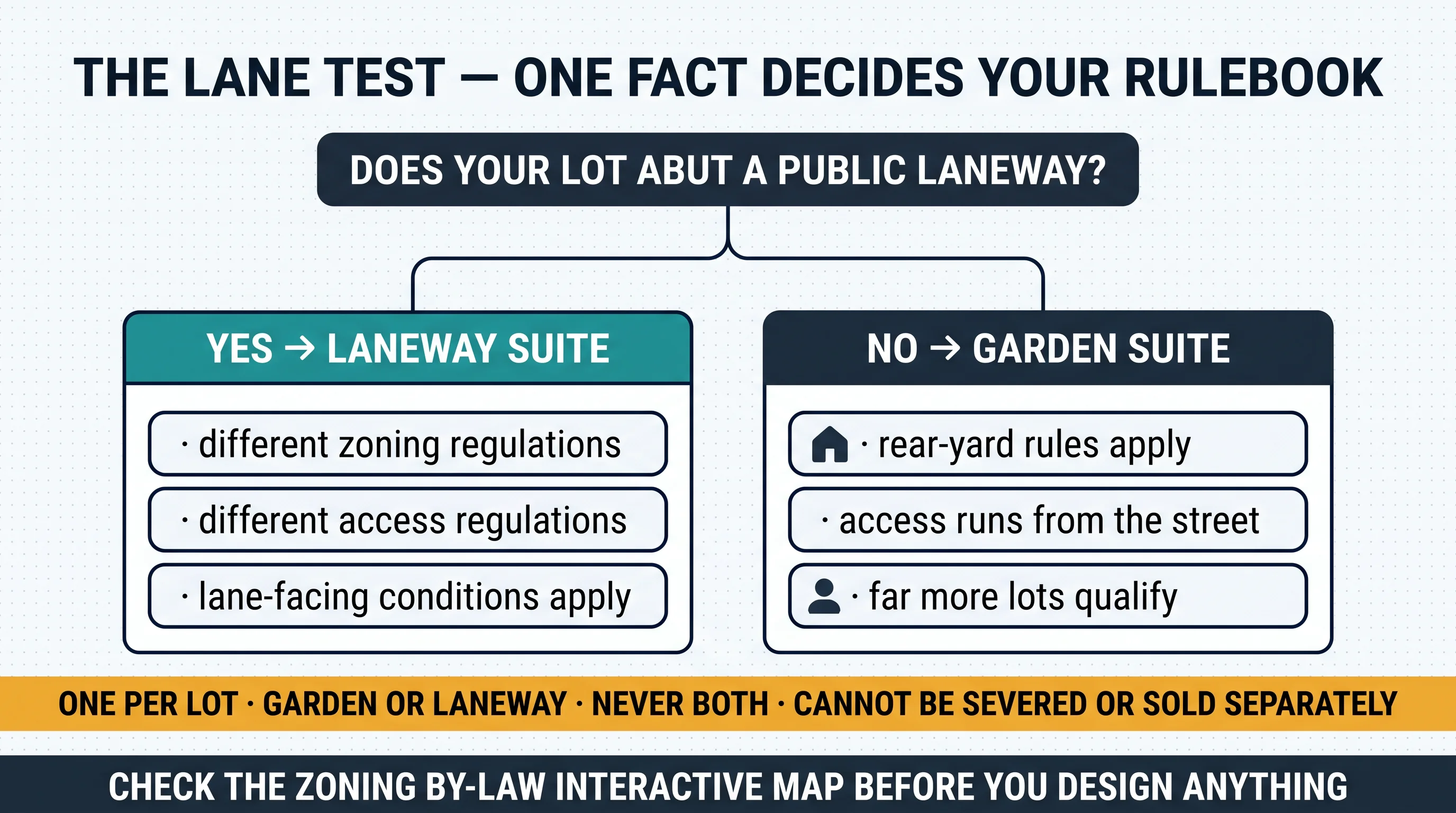

Panel titled The Lane Test — One Fact Decides Your Rulebook. A question chip reads does your lot abut a public laneway. Yes leads to laneway suite: different zoning regulations, different access regulations, lane-facing conditions apply. No leads to garden suite: rear-yard rules apply, access runs from the street, far more lots qualify. An amber band reads one per lot, garden or laneway, never both, cannot be severed or sold separately. Footer reads check the Zoning By-law Interactive Map before you design anything.

The definitions are close cousins. A laneway suite is a self-contained residential unit on the same lot as a detached house, semi-detached house or townhouse, generally in the rear yard next to a laneway. A garden suite is the same idea without lane access — reached from the street through a side yard or alongside the main house. Both are detached, both are genuinely self-contained (own kitchen, own bathroom, own entrance), and both share the main house's services.

The distinction is substantive, not cosmetic. Lane adjacency changes setbacks, access rules and height logic, and the City confirms that access requirements differ between the two. So the first thing to establish isn't your budget or your floor plan — it's which document applies to you.

You get one. The City is explicit that a single garden suite containing a single unit is permitted on a property. Garden or laneway. Never both.

And you can't sell it. A backyard suite can't be severed from the main lot or sold separately. That matters more than it sounds — severance is precisely the event that detonates the development charge deferral, which we'll get to.

One last thing before you go looking for numbers. Laneway suites have been permitted since 2018; garden suites were legalized in 2022; the rules were updated in 2025. Different sources call the governing document 89-2022, 569-2013, 847-2025, 849-2025 — and one confidently cites "569-2020," which does not exist. Look your property up on the Zoning By-law Interactive Map and read the by-law as currently amended. Height, for example, is measured from average grade — not from your patio, and not from wherever your tape measure happens to land.

Where does this sit if you've been following the series? The basement apartment is unit two. The backyard suite is unit three. Same house, same lot, entirely different rulebook. If you're weighing which Toronto neighbourhoods support this kind of project at all, the Toronto investor guide is the place to start; if this would be your first rental, start with becoming a landlord in Ontario.

The Blockers That Aren't in the By-law

This is the section that separates a project from a hobby. You can read the zoning by-law cover to cover, meet every setback, and still not be able to build. Two reasons, and neither one is in that document.

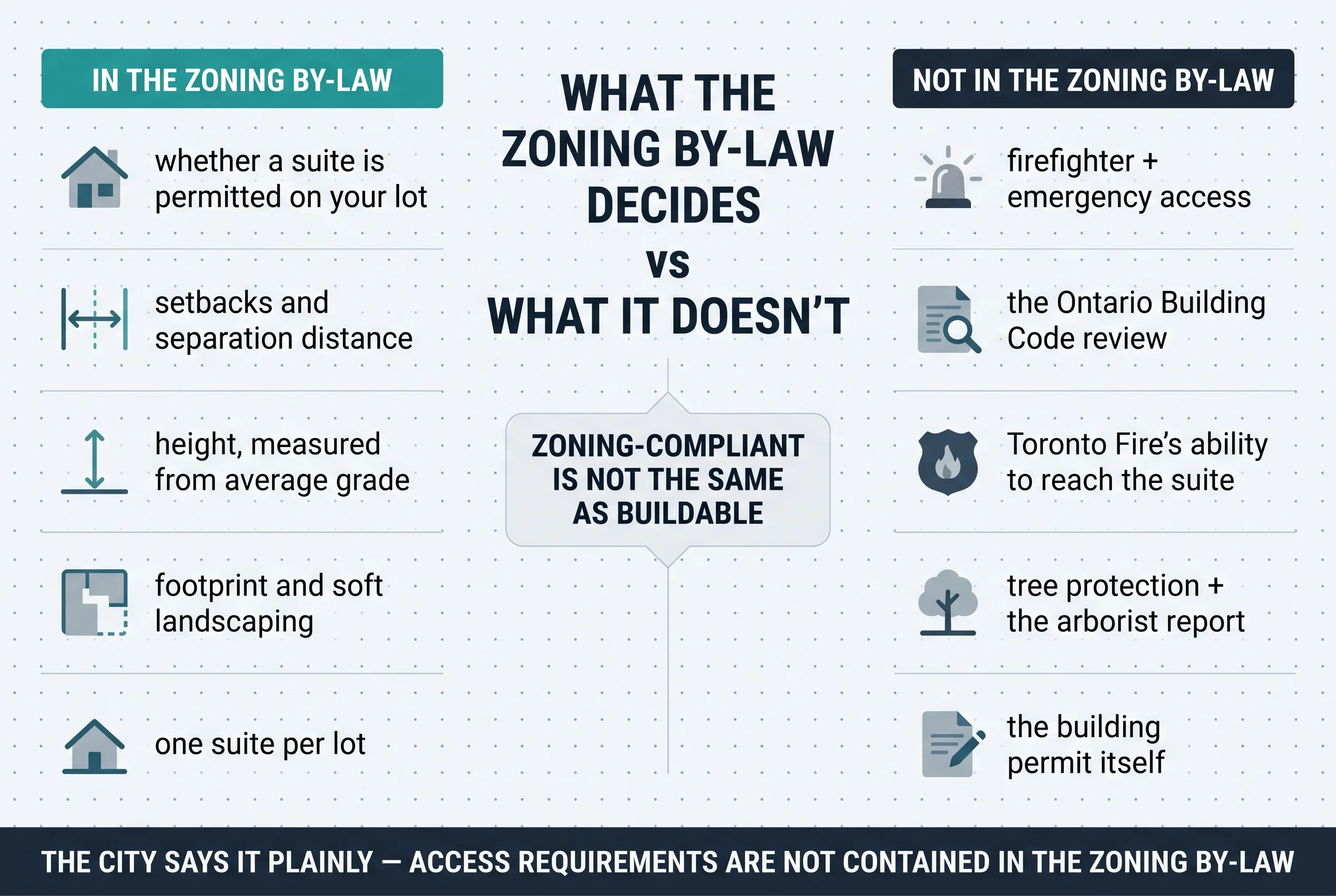

Scorecard comparing what the zoning by-law decides (whether a suite is permitted on your lot, setbacks and separation distance, height measured from average grade, footprint and soft landscaping, one suite per lot) with what it doesn't (firefighter and emergency access, the Ontario Building Code review, Toronto Fire's ability to reach the suite, tree protection and the arborist report, the building permit itself). Centre divider reads zoning-compliant is not the same as buildable.

Reason one: emergency access

In the City's own words, the firefighter and emergency access requirements "are not contained in the zoning by-law" — they're determined through an Ontario Building Code compliance review conducted by Toronto Building and Toronto Fire and Emergency Services.

The City's framing here is not bureaucratic. The Building Code requires acceptable emergency access because it is, as the City puts it, critical to saving lives and preventing the spread of fire — and Toronto Fire must be able to reach every building in the city with firefighting equipment. For laneway suites the City cites the sections directly: principal access per Building Code Division B, 9.9.2.4, and fire access per Division B, 9.10.20.3. And the requirements differ between garden and laneway suites — one more reason the lane test comes first.

Builders describe a clear path from the street to the rear yard that has to stay unobstructed by fences and air-conditioning units. Treat the specific dimensions as something to confirm with the City, not something to read off a blog.

Reason two: the tree

The City requires an arborist report "for all projects where there is a potential for damage to private or City trees," and the applicant is responsible for complying with tree protection by-laws besides. Where trees may be affected, the City advises talking to City Planning and Urban Forestry about how the design can be accomplished while protecting the healthy trees in question.

Read that as three approvals, not one: a suite must comply with the zoning by-law, the Building Code, and tree regulations. Most people never think about the third until the arborist arrives. One builder's summary of the two blockers together is blunt — fire access failures and conflicts with protected trees are the top blockers. A lot in Etobicoke that meets the by-law on paper can still stall over a single mature oak.

A narrow clear side passage between an older brick house and a wooden fence, running from the front of the lot toward a green rear yard, with a mature tree trunk and canopy pressing in close on one side and a tidy path underfoot, in calm even daylight.

The permitted-garage rule — the trap with teeth

Here's the one that catches people who thought they were ahead. Existing structures get relief from setbacks and separation distance to the main house — "so long as the structure was constructed with a building permit. If the existing structure was constructed without a building permit, it will be treated as a 'new building' regardless of how long it has existed."

Your 40-year-old garage is grandfathered only if somebody pulled a permit in 1986. If they didn't, age buys you nothing at all. That's the basement apartment's existing-unit trap wearing a different hat — and it's the best argument in this whole cluster for why a permit is worth having decades before you need it.

Pro Tip: Check the access route and the trees in concept design — before you pay anyone for drawings. These are the two items most likely to change your plan or end it, and both are cheaper to discover with a tape measure and a phone call than after a designer has billed you. Urban Forestry would much rather talk to you at the sketch stage than at permit.

"Pre-approved" is not approved

The City now offers free "Made in Toronto" pre-approved plans for garden and laneway suites — reviewed by Toronto Building, and found to comply with the Building Code and the City's zoning by-law. The value is real: you still apply for a permit, but you upload a site plan only and identify the plan type in your description of work.

Then read the City's own caveat, which is a verify-lesson in one sentence: "Meeting these requirements does not guarantee that your garden or laneway suite will be compliant with zoning or other applicable law. A full review is required as part of the building permit application process." The plans clear the building. Your lot is still yours to prove.

One more the plans won't solve for you: where the suite's piping connects to the main building's services, the City notes this "could constitute a material alteration to the main building" under the Building Code. That's a sentence worth putting in front of your designer early rather than late.

The Money: The Program You've Read About Is Probably the One You Don't Need

Start with the headline, because it inverts most of what's published on this topic. Search "laneway suite development charges" and you'll be told to apply for Toronto's DC Deferral Program. It's real — Council approved it in April 2018 — and for most readers of this article, it is now the wrong tool.

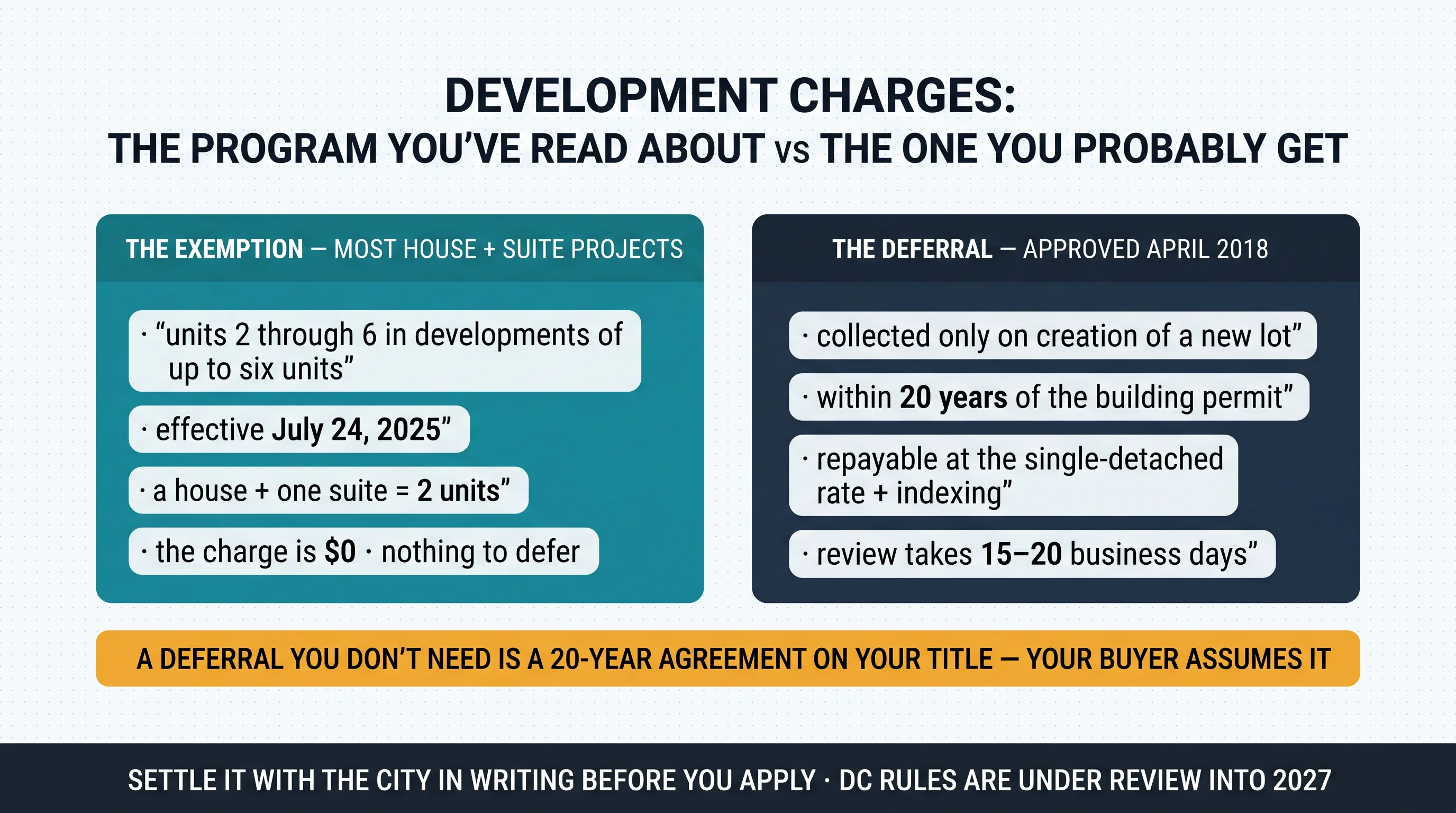

Illustration titled Development Charges: the program you've read about versus the one you probably get. The exemption card: units two through six in developments of up to six units, effective July 24 2025, a house plus one suite equals two units, the charge is zero with nothing to defer. The deferral card, approved April 2018: collected only on creation of a new lot, within 20 years of the building permit, repayable at the single-detached rate plus indexing, review takes 15 to 20 business days. An amber band reads a deferral you don't need is a 20-year agreement on your title — your buyer assumes it.

What changed. In 2025 Council adopted EX24.2 and MM32.5, which added exemptions for developments with up to six units — covering the second, third, fourth, fifth and sixth unit, effective July 24, 2025. A house with a garden suite is two units. The development charge is zero. There is nothing to defer.

So what does the deferral actually do to you? It's an agreement, and it has a long tail. The City's terms: the charge would only be collected through creation of a new lot — a Plan of Subdivision, Plan of Condominium, or Consent to Sever — within 20 years of the issuance of the building permit. You can repay any time in those 20 years, at the rate for a single detached unit, plus annual indexing. Review takes 15–20 business days, and the City recommends applying as soon as you apply for the permit.

Warning: The title trap — and if you read our vacant home tax guide, you've seen this shape before. A deferral agreement runs with the property. The buyer of your house must assume it. Severing the suite triggers default, at which point the charges are recalculated at the current year's rate — so the liability grows with time. The seller has to disclose the restriction on a listing, and a buyer should have a lawyer title-search for it before making an offer. Same lesson as the vacant home tax: municipal instruments attach to the property, not the person. Confirm the mechanics with a real estate lawyer — this is the kind of thing you want in writing before closing, not after.

And the pincer. From the other direction, one builder warns that paying development charges in error means losing the deferral permanently — the City won't credit it back. So both mistakes are live: taking a deferral you never needed, and paying a charge you were exempt from. Which is exactly why the money question has to be settled before the permit application, in writing, with the City. Note too that the City requires the owner to provide "evidence to the satisfaction of the City" of entitlement to any exemption — it isn't automatic just because you qualify.

The famous loan is gone. The $50,000 forgivable loan still promoted across the internet no longer exists. The City's own words: "Due to insufficient provincial program funding, the Affordable Laneway Suites Program has been discontinued and is not expected to be reactivated." There's no replacement as of 2026. If a page is still selling you on it, that page is telling you how old it is — and giving you a good reason to check everything else on it.

What it costs to build — with the usual health warning. Published ranges come from firms that sell the work, and they don't reconcile: $310,000–$470,000 turn-key for a typical small suite; $400–$550 per square foot for garden suites and $450–$600 for laneway; $300–$400+ per square foot; and one "built for $275,000." Run those against each other and you get roughly a fourfold spread on the same product. That is not a budget. It's proof you need a quote on your lot. For how the carrying costs work once it exists, see the true monthly cost breakdown.

Timelines are quoted at 9–12 months from first drawing to occupancy with no variance, plus 3–6 months if you need a minor variance, and another 4–6 weeks in a heritage district. That's the real argument for designing inside the by-right envelope first and only pushing for variances if the program genuinely won't fit.

What It Rents For, and What's Coming

The honest limit first: there is no authoritative rent series for laneway or garden suites. CMHC doesn't survey them. The numbers circulating — a well-located two-bedroom laneway suite at $3,000–$3,300 a month — come from brokerages with something to sell, and can't be checked. Price from local comparables, not from a guide.

What CMHC can tell you is the conditions, not the number. Toronto's purpose-built vacancy reached 3.0%, the first time since the pandemic. Asking rents are declining in Toronto. And landlords are leaning on incentives, which CMHC says have intensified over the past six months, reaching as high as several months of free rent. Competition from investor-owned rental condos is higher than usual, and new units are taking months to fill.

Why that matters for a backyard suite specifically: it's a secondary-market unit. It resets to market on turnover, so it tracks asking rents — the softening ones — not the guideline. A suite completing in 2026 leases into a market where brand-new purpose-built product down the street may be offering free months. That's not a reason not to build. It's a reason not to underwrite the project on a brokerage's rent estimate.

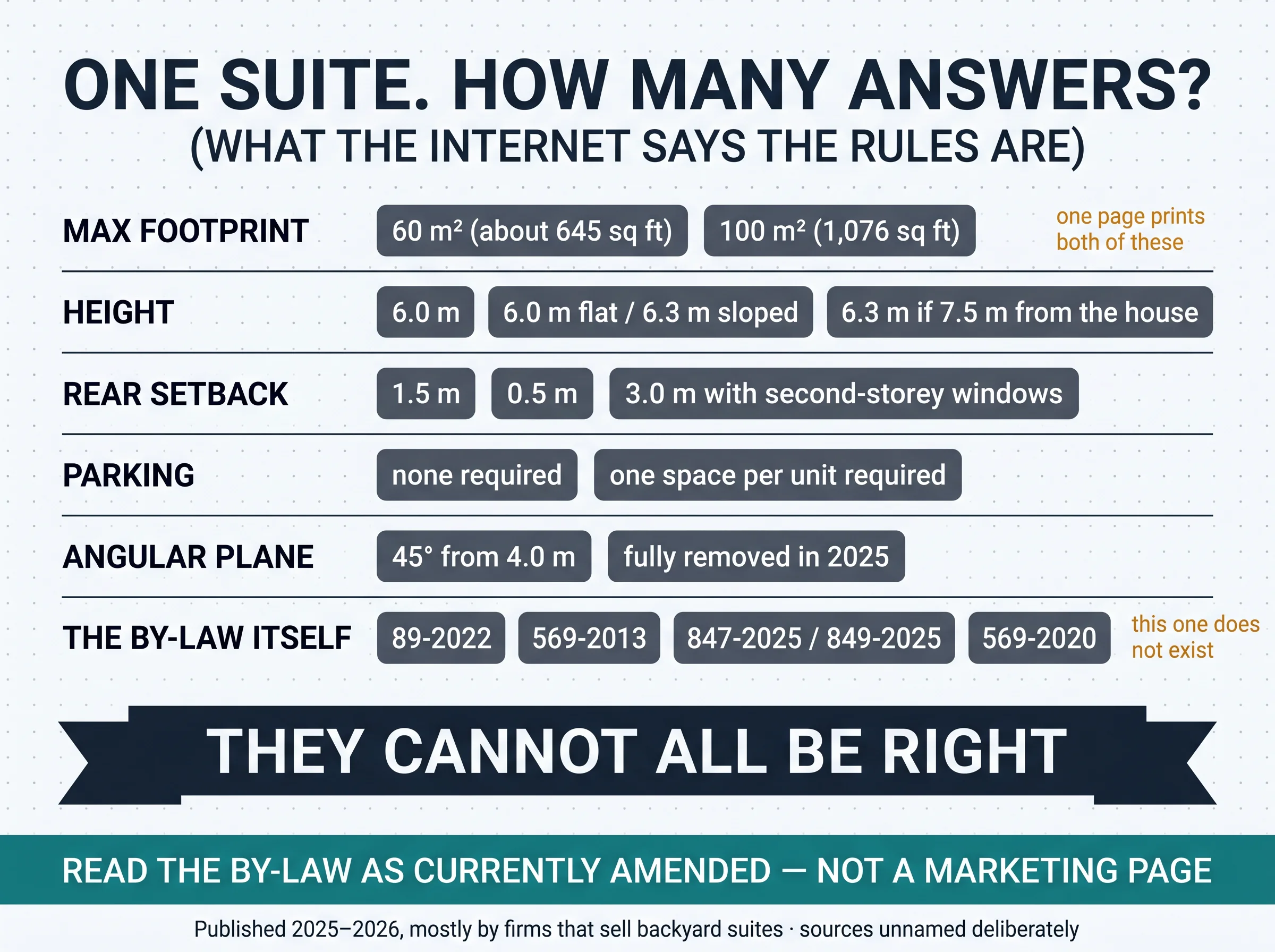

Panel titled One Suite. How Many Answers? Rows list conflicting published answers in identical neutral tone with none marked correct. Max footprint: 60 square metres or 100 square metres, with a note that one page prints both of these. Height: 6.0 m, or 6.0 m flat and 6.3 m sloped, or 6.3 m if 7.5 m from the house. Rear setback: 1.5 m, 0.5 m, or 3.0 m with second-storey windows. Parking: none required, or one space per unit required. Angular plane: 45 degrees from 4.0 m, or fully removed in 2025. The by-law itself: 89-2022, 569-2013, 847-2025 and 849-2025, or 569-2020 — with a note that this one does not exist. A ribbon reads they cannot all be right.

Which brings us to the numbers themselves. Ask the internet how big a garden suite can be and you'll be told 60 square metres and 100 square metres — on the same page. Ask whether you need parking and you'll be told both that none is required and that one space per unit is required. Ask about the rear setback and you'll get 1.5 metres or 0.5 metres depending who's selling. Ask whether the angular plane still applies and you'll find it described as a live requirement in one place and as "fully removed in the 2025 update" in another.

They cannot all be right. And there's a wrinkle here that goes further than "don't trust contractors": the City's own published summary of the garden suite rules is dated February 2022 — before the 2025 by-law update — and it carries its own caveat that it "is not intended to be exhaustive" and "is subject to change." If a municipal summary can sit on the internet for four years while the by-law underneath it moves, then the by-law as currently amended is the only thing worth relying on. That's the method: the Interactive Map for your property, the by-law as amended for the rules, and Toronto Building for anything still unclear.

The rules that travel: the tenant in your backyard is a full RTA tenant — Ontario Standard Lease, the guideline and an N1 for increases, last month's rent only, no late fees, and the $20 NSF cap. And short-term rental isn't the escape hatch: it needs a licence and the unit must be your principal residence, which your backyard suite generally isn't if you live in the main house. Model an increase with the rent increase calculator.

What's coming — and this section has a shelf life the City itself admits to. Development charge indexing was removed for 2025 and 2026 and resumes after 2026. The Province amended the Development Charges Act through Bill 17, with changes in force June 5, 2025 and November 3, 2025. And the City is in the early stages of a Comprehensive Development Charges Review, expected to continue into 2027. The note on the City's own development charges page reads: "The information on this website is intended only as a guide." If a rule in this section matters to your budget, confirm it the week you apply — not the month you read about it.

The direction of travel is real, though, and it's worth reading correctly. Toronto has been consistently loosening: laneway suites in 2018, garden suites in 2022, four units as-of-right, the six-unit development charge exemption, updated suite by-laws in 2025, and free pre-approved plans. The Garden Suites Monitoring Program — which reported to the Planning and Housing Committee in February 2024 — is explicitly reviewing built form, tree protection, soft landscaping and the variance process to find any "additional barriers." That's a city looking for reasons to say yes. It is not a city that has stopped requiring a permit.

The Backyard Suite Feasibility Checklist

Before you pay a designer, find out whether your lot can actually take a suite. Eighteen checks in the order that matters — starting with the one lot line that decides your entire rulebook, and the two blockers that aren't in the zoning by-law at all.

Get Free PDF →

Key Takeaways: Check the Lane, Then Check the Way In

Seven moves that keep a backyard suite project honest:

  1. Run the lane test first. Does your rear or side lot line touch a public laneway? It decides which rulebook, which setbacks and which access rules — before anything else.
  2. Check the access route before the design. Emergency access isn't in the zoning by-law; it's a Building Code review by Toronto Building and Toronto Fire, and it's one of the two most common blockers.
  3. Walk your yard and look up. A protected tree can end a design, an arborist report is required wherever City or private trees could be damaged, and Urban Forestry would rather talk to you in concept than at permit.
  4. Find out whether your old garage was permitted. The setback relief for existing structures depends entirely on that, and age is not a substitute.
  5. Settle the development charge question in writing before you apply. Most house-plus-suite projects are now exempt, and taking a deferral you don't need puts a 20-year agreement on your title.
  6. Buying a house that already has a suite? Have your lawyer title-search for a deferral agreement. You would be assuming it.
  7. Take every dimension from the by-law as currently amended — not from a guide. The published figures contradict each other, and one of them cites a by-law that doesn't exist.

Quick win: pull up the Zoning By-law Interactive Map and check whether you abut a public lane. Two minutes, and it determines the entire project. Long game: the permitted, inspected suite is the one that's insurable, financeable and sellable — and the permit you pull today is what makes the next project on that lot possible.

The Bottom Line

One lot line decides your rulebook. You get one suite, and you can't sever it. And the two things most likely to stop you — emergency access and a tree — aren't in the by-law you were reading. That's the pattern this whole cluster has been circling: the rule you can find is rarely the rule that binds.

The money has the same shape. The program every guide recommends is one most readers no longer need, because the charge on a house-plus-suite is now zero. The loan every guide still promotes is discontinued and isn't coming back. And the deferral that looks like a favour is an agreement your buyer inherits and severance detonates. So do it in this order: check the lane, check the access, check the trees, read the by-law as currently amended, and settle the development charges in writing before you apply. Everything published about this topic — including this article — has a shelf life, and the City's own review runs into 2027. A framework and a method, not legal or construction advice.

Build it right. Then rent it right.

Tenon10 keeps your leases, documents and Ontario's rules organized in one place — for the backyard suite and the house in front of it. Free to start.

See Plans & Current Rates → tenon10.com/pricing

Free • No signup required • Updated for the Bill 60 changes in force 21 Sep 2026

Frequently Asked Questions

What's the difference between a garden suite and a laneway suite in Toronto?

One fact: whether your property abuts a public laneway. If your rear or side lot line touches a public lane, you're building a laneway suite. If it doesn't, you're building a garden suite. The City routes you this way on its own pages, and the distinction is substantive, not cosmetic — lane adjacency changes setbacks, height logic, and access requirements, and the City confirms that access requirements differ between the two. Both are detached, self-contained homes in the rear yard of a detached house, semi-detached house or townhouse, with their own kitchen, bathroom and entrance, sharing the main house's services. Two other rules matter as much: you're permitted one — a garden suite or a laneway suite, not both — and it cannot be severed from the lot or sold separately. Start every project by checking the Zoning By-law Interactive Map to confirm your zoning and whether you have lane access. It takes two minutes and it determines which rulebook applies to everything that follows.

Can I build a garden suite if my lot is zoning-compliant?

Not necessarily — and this is the most expensive misunderstanding in the topic. Zoning is only one of the approvals. The City states plainly that firefighter and emergency access requirements "are not contained in the zoning by-law"; they're determined through an Ontario Building Code compliance review conducted by Toronto Building and Toronto Fire and Emergency Services. Toronto Fire has to be able to reach the suite with firefighting equipment, and for laneway suites the City points to specific Building Code sections for principal access and fire access. Separately, tree protection applies: an arborist report is required wherever City or private trees could be damaged, and one mature protected tree can end an otherwise compliant design. Builders name those two — fire access and protected trees — as the top blockers. So a lot can satisfy every setback in the by-law and still not support a suite. Check the access route and the trees in concept design, before you pay for drawings.

Do I have to pay development charges on a garden suite in Toronto?

For most house-plus-suite projects, no — and this is where the internet is out of date. In 2025 City Council added exemptions for developments with up to six units, covering the second through sixth units, effective July 24, 2025. A house with a garden suite is two units, so the development charge is zero. That matters because almost every guide still tells you to apply for the City's DC Deferral Program, approved back in April 2018. If you're exempt, there is nothing to defer — and the deferral is an agreement that runs with your property for 20 years, restricts severance, must be assumed by whoever buys the house, and comes due at the current year's rate if triggered. The deferral is aimed at projects that go beyond six units. Note also that development charge rules are moving: indexing was removed for 2025 and 2026 and resumes after, and the City's Comprehensive Development Charges Review runs into 2027. Confirm your treatment with the City in writing before you apply for the permit.

Is there still a $50,000 forgivable loan for laneway suites in Toronto?

No. The City's own words: "Due to insufficient provincial program funding, the Affordable Laneway Suites Program has been discontinued and is not expected to be reactivated." There is no replacement as of 2026. You will still find pages promoting the $50,000 forgivable loan — that's a good signal of how old the page is, and a good reason to check anything else on it. What remains is the development charge picture described above, which for most single-suite projects is better than a loan anyway: an exemption rather than a debt. If you see a grant or loan program named on a builder's page, verify it directly on toronto.ca before you build a budget around it.

Can I rent out my garden suite on Airbnb?

Generally not, if you live in the main house. Toronto's short-term rental rules require a licence and the unit must be your principal residence — the place where you live and the address you use on your ID and taxes. A garden suite in the backyard of the home you live in usually isn't your principal residence, so it typically doesn't qualify for short-term rental. As a long-term rental it's straightforward: if the suite has its own kitchen, bathroom and entrance and the building permit was issued for residential occupancy, you can rent it on a standard lease. And that tenancy is a full one — your backyard tenant has the same Residential Tenancies Act rights as anyone else, which means the Ontario Standard Lease, the guideline and an N1 for increases, last month's rent only, no late fees, and the $20 NSF cap.

This article is general information for Toronto landlords and investors, current as of July 15, 2026. It is not legal, construction or engineering advice, and it deliberately states no dimensional requirement — no footprint, height, setback or separation figure — because the published figures openly contradict one another and only Zoning By-law 569-2013 as currently amended governs your lot. The conflicting figures shown above are reproduced as examples of contradictory published claims, not as statements of what the by-law requires. Rules, fees and programs are dated July 2026: Toronto's garden and laneway suite zoning was updated in 2025, the development charge exemption for developments of up to six units took effect July 24, 2025, development charge indexing is removed for 2025 and 2026 and resumes after, the City's Comprehensive Development Charges Review is expected to continue into 2027 — and the City's own published summary of the garden suite rules is dated February 2022. Verify the current by-law and program terms with the City of Toronto, and confirm any development charge deferral agreement with a real estate lawyer, before relying on any figure, including the ones in this article. Sources: City of Toronto (garden suites, laneway suites, pre-approved plans, development charges and the deferral program) and CMHC, 2026.

Was this guide useful?

Written by

Krishnaa Kedia

Content Editor

Krishnaa is a content editor at Tenon10, crafting guides and resources for Canadian landlords, tenants, and property managers.

Stay in the loop

Get the latest insights on property management delivered to your inbox.

I am a:
